Investments

Kalindi Kunj Gets 2 New Flyovers: How Delhi, Noida & Faridabad Traffic Will Change

Kalindi Kunj Gets 2 New Flyovers: How Delhi, Noida & Faridabad Traffic Will Change

15 Jul 2026

Content

No Blogs content found

It looks like there haven’t been any blogs yet!

Get answer to all your queries

We're here to help

Talk to Expert

Every day, thousands of vehicles from Noida, Delhi and Faridabad converge at one of NCR's busiest intersections Kalindi Kunj. What should be a two-minute crossing often turns into multiple signal cycles during peak hours. To solve this long-standing bottleneck, the National Highways Authority of India (NHAI) has approved two new flyovers designed to transform the junction into a signal-free interchange.

Here's the complete, verified breakdown of what's being built, what stage the project is at, and what still isn't confirmed.

Quick Facts: Kalindi Kunj Flyover Project

ProjectTwo loop flyovers + junction widening, Kalindi Kunj
Implementing AuthorityNHAI (National Highways Authority of India)
Estimated Cost~₹500 crore (sanctioned by Union Minister Nitin Gadkari)
Number of Flyovers2 loop flyovers + 1 related Madanpur Khadar–Noida link, per DPR
DPR StatusCompleted and approved (April 8, 2026)
Construction Start DateNot officially announced
Completion TimelineNot officially announced
Key BeneficiariesNoida, Faridabad, Jasola, Sarita Vihar, Shaheen Bagh, Okhla, Delhi–Mumbai Expressway commuters

Why Kalindi Kunj Is One of Delhi-NCR's Worst Traffic Bottlenecks

To understand why this particular junction jams up so badly, it helps to look at a map rather than a traffic report.

Kalindi Kunj sits on the Yamuna's western bank, right where the Delhi–Noida border meets the road network heading toward Faridabad. According to Union Minister of State for Road Transport and Highways Harsh Malhotra, six roads physically intersect at this one junction a scale of convergence he compared to Delhi's Dhaula Kuan interchange.

Here is what actually merges here:

  • Noida-bound traffic crossing the Kalindi Kunj Bridge over the Yamuna from South Delhi (Jasola, Sarita Vihar, Kalkaji, Greater Kailash-II).
  • Delhi-bound traffic entering from Noida sectors roughly between Sector 37 and Sector 62.
  • Faridabad and Badarpur traffic using Road No. 13A and the Agra Canal Road.
  • Shaheen Bagh and Jamia Nagar traffic entering via Okhla and Road No. 13.
  • Delhi–Mumbai Expressway traffic, specifically the DND–Faridabad–KMP spur (NH-148NA), which uses the Kalindi Kunj metro station area as one of its two Delhi entry/exit points.
  • Local traffic to and from the Okhla Bird Sanctuary, Okhla Barrage Road, and the Kalindi Kunj metro station itself. An internal communication from Delhi Traffic Police to NHAI, accessed by regional outlet The Press Reporter, described the problem precisely: heavy traffic volume converges from three sides — Road No. 13 (Shaheen Bagh to Noida), Noida to Delhi, and Faridabad to Noida — and after sections of the Delhi–Mumbai Expressway opened, Faridabad/Badarpur-to-Noida traffic surged further, creating what the document called "an extended tail" at the junction.

Did You Know? Kalindi Kunj isn't just a local red light, it's the point where inter-state commuter traffic (Delhi↔Noida), inter-city expressway traffic (Faridabad↔Mumbai corridor), and seasonal religious traffic (this is also a major Kanwar Yatra route) all fight for the same at-grade intersection at once.Kalindi Kunj isn't just a local red light — it's the point where inter-state commuter traffic (Delhi↔Noida), inter-city expressway traffic (Faridabad↔Mumbai corridor), and seasonal religious traffic (this is also a major Kanwar Yatra route) all fight for the same at-grade intersection at once.

Kalindi Kunj Junction Map: Current vs Future Traffic Movement

The easiest way to understand this project is visually. The diagram below shows how traffic currently funnels through the single signalised junction (red, dashed) versus how the two new loop flyovers will let vehicles bypass the signal entirely (green).

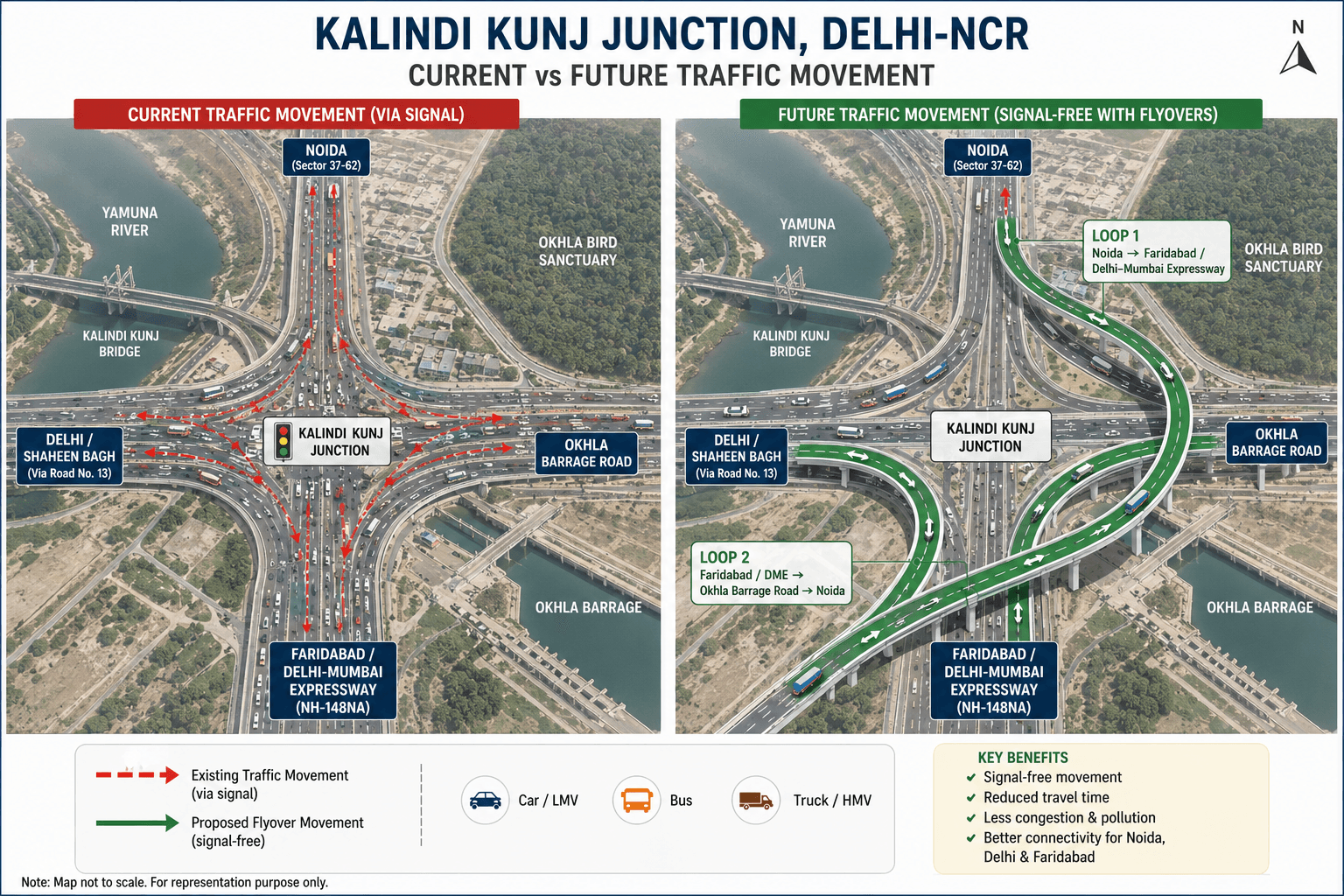

current vs after.png

Kalindi Kunj Traffic Update: What's Verified Right Now

It's worth being precise here, because most coverage of this project cites general "chronic congestion" without hard numbers.

What is officially documented:

  • Delhi Traffic Police signal-timing records for the Kalindi Kunj junction (Junction Code M-53) show a structured multi-phase signal cycle that runs for extended durations up to roughly two minutes per full cycle during peak windows (8:00–11:00 AM and 5:00–9:00 PM) reflecting how many conflicting traffic movements the signal has to manage.
  • The Central Road Research Institute (CRRI) analysed traffic patterns at Kalindi Kunj using data drawn from the metro station and surrounding arterial roads, and concluded that traffic from South Delhi, Noida, and Faridabad converges here in a way that creates severe delays during rush hours.
  • Delhi Traffic Police has repeatedly issued advisories citing recurring, severe congestion at Kalindi Kunj for instance during the 2024 and 2025 Kanwar Yatra periods, when commuters reported jams so bad that covering roughly one kilometre took close to two hours, and single vehicle breakdowns on the Yamuna Bridge escalated queues significantly.

What is not officially available: NHAI, MoRTH, and Delhi/Noida Traffic Police have not published a formal, quantified peak-hour vehicle count (PCU/hour) or average wait-time study specifically for the Kalindi Kunj junction in the public domain. Where news reports mention travel-time figures (for example, "one to one-and-a-half hours" cited by Minister Malhotra), that figure referred specifically to the separate Ashram–Badarpur corridor, not Kalindi Kunj itself — we have kept these two figures distinct rather than conflating them.

Why Two New Flyovers Were Needed

The core engineering problem at Kalindi Kunj is that turning traffic and through traffic currently share the same at-grade signal. Left-turning and right-turning vehicles from four different approach roads all have to take their turn at a red light, which is why the signal cycle runs so long.

The proposed fix follows a well-established road engineering principle: separate the turning movements from the through movements using dedicated loop ramps (also called "loop roads"), so vehicles that only need to turn never have to stop at the main signal at all. This is broadly the same design logic used at Delhi's Dhaula Kuan interchange and the Modi Mill flyover both cited by officials as reference points for the Kalindi Kunj plan.

Detailed Design of Flyover 1 (Loop 1)

Route: Noida → (via Kalindi Kunj Bridge) → left-turn loop → Faridabad / Delhi–Mumbai Expressway

According to officials involved in the DPR review, this loop is built for commuters travelling from Noida across the Kalindi Kunj Bridge who want to continue toward Faridabad or join the Delhi–Mumbai Expressway (the DND–Faridabad–KMP spur). Instead of merging into the main signalised junction and waiting for a green light to turn, these vehicles will peel off onto a dedicated left-turning loop ramp that bypasses the intersection entirely.

Purpose: Removes one of the heaviest conflicting movements — Noida-to-Faridabad/Expressway traffic from the main signal cycle, which is also one of the flows that has grown the most since Delhi–Mumbai Expressway sections opened.

Detailed Design of Flyover 2 (Loop 2): The Okhla Barrage Flyover Connection

Route: Faridabad / Delhi–Mumbai Expressway → loop → Okhla Barrage Road → Noida

The second loop serves traffic moving in the opposite direction — commuters and freight coming from Faridabad and the Expressway side who are headed toward Noida. This loop connects directly into Okhla Barrage Road, again allowing vehicles to avoid stopping at the main Kalindi Kunj signal.

The DPR also describes a related link: a flyover connecting the Madanpur Khadar police intersection (referred to as Khadar Puliya in some official communication) directly to Noida, with a return link from Noida back to Khadar Puliya — effectively giving this movement a two-way grade-separated connection independent of the main junction.

Purpose: Removes the Faridabad/Expressway-to-Noida movement — the flow officials say has increased most sharply since the Delhi–Mumbai Expressway's Faridabad sections opened from the signalised intersection.

How the Junction Will Change: Kalindi Kunj Signal-Free Corridor

This is one of the most misunderstood parts of the project, so it's worth stating plainly based on official statements:

  • The existing at-grade intersection will not be demolished or replaced — it will continue to function.
  • It will be converted into a signal-free junction once the two loops absorb the turning traffic.
  • Selected stretches of the existing intersection will be widened to smooth out the remaining through-movements.
  • The overall approach is being described by MoRTH as an "interchange," comparable in concept (not necessarily in scale) to the Dhaula Kuan interchange in Delhi.

Before vs After: How Specific Journeys Will Change

Noida → Faridabad / Delhi-Mumbai Expressway
Current: Stop at the Kalindi Kunj traffic signal, wait through the left-turn phase.
Future: Use the dedicated Loop 1 ramp — no signal stop required.

Faridabad / Expressway → Noida
Current: Merge across the signalised junction, competing with cross-traffic.
Future: Use Loop 2 via Okhla Barrage Road — no signal stop required.

Madanpur Khadar ↔ Noida
Current: Routed through the main junction along with all other movements.
Future: Direct flyover link with a return connection, per the approved DPR.

Through-traffic not covered by the loops
Current: Multi-phase signal, long cycle times, frequent queue build-up.
Future: Widened, signal-free at-grade crossing with fewer competing turns.
AspectExisting MovementProposed Movement (Post-Project)
Noida → Faridabad/ExpresswayLeft turn at signalised junction, waits for green phaseDedicated Loop 1 ramp, bypasses signal entirely
Faridabad/Expressway → NoidaCrosses/merges at signalised junctionDedicated Loop 2 ramp, connects to Okhla Barrage Road, bypasses signal
Madanpur Khadar ↔ NoidaRouted through main junctionDirect flyover link with return connection, per DPR
Remaining through-trafficMulti-phase signal, long cycle timesWidened, signal-free at-grade crossing

Who Will Benefit: Noida-Delhi-Faridabad Connectivity

AreaBenefit
Noida (Sectors 37–62 corridor)Faster, signal-free access to South Delhi and onward to the Delhi–Mumbai Expressway toward Faridabad
Faridabad / BallabhgarhSmoother connection into Noida without queuing at the main signal, once the DND–Faridabad link of the Expressway is fully operational
Jasola, Sarita ViharReduced spillback congestion on approach roads that currently back up due to the signal at Kalindi Kunj
Shaheen Bagh, Jamia NagarLess cross-traffic conflict on Road No. 13/13A during peak hours
Okhla, Madanpur KhadarDirect flyover access to Noida per DPR, bypassing local congestion
Delhi–Mumbai Expressway usersCleaner entry/exit at the Kalindi Kunj metro station access point of the DND–Faridabad–KMP spur

Daily Routes That Will Benefit Most

To make this concrete, here are the kinds of everyday commutes this project is aimed at — based on the movements the DPR is designed around, not an official route-by-route list:

  • Noida Sector 150 → Jasola (via Kalindi Kunj Bridge, currently signal-dependent)
  • Noida Sector 37 → Sarita Vihar / South Delhi
  • Greater Noida → Faridabad (via the Kalindi Kunj–Expressway connection)
  • Noida Sector 18 → Delhi–Mumbai Expressway (toward Faridabad, Sohna, Mumbai corridor)
  • Faridabad → Noida (reverse commute, currently one of the most conflict-heavy movements at the junction)

Kalindi Kunj Flyover Timeline: From Feasibility Study to Approval

kalindi-kunj-project-timeline.svg

StageCurrent Status
Feasibility studyCompleted by UP Public Works Department (2022), later followed by a CRRI traffic-pattern analysis
Consultant appointment for DPRNHAI invited consultant bids in June 2025 (submissions due June 23, 2025)
Delhi Traffic Police formal requestSent to NHAI in August 2025
DPR preparation update to ParliamentMoS MoRTH Harsh Malhotra told the Lok Sabha (February 6, 2026) that DPRs were being prepared
DPR completion & NHAI approvalDPR finalised and presented to Delhi Traffic Police, Noida Traffic Police, and NHAI on April 8, 2026; project approved
Budget sanctionApproximately ₹500 crore sanctioned by Union Minister Nitin Gadkari
Implementing agencyNational Highways Authority of India (NHAI)
Construction start dateNot officially announced
Completion timelineNot officially announced

NHAI has not published a start date, contractor award, or expected completion year for the two loop flyovers as of July 2026. Any date you see mentioned elsewhere for "when the flyover opens" should be treated as speculation unless it cites a specific NHAI or MoRTH statement, we have not found one.

Flyover Comparison Table

FlyoverRoutePurposeMajor Benefit
Loop 1Noida (via Kalindi Kunj Bridge) → Faridabad / Delhi–Mumbai ExpresswayBypass main signal for left-turning trafficRemoves Noida-to-Faridabad conflict from junction
Loop 2Faridabad / Delhi–Mumbai Expressway → Okhla Barrage Road → NoidaBypass main signal for opposite-direction trafficRemoves Faridabad-to-Noida conflict, the fastest-growing flow post-Expressway

Impact on Daily Commuters

For the daily commuter, the practical change (once built) is straightforward: if your trip only involves a turning movement covered by one of the two loops, you will no longer need to stop at the Kalindi Kunj signal at all. If your trip crosses straight through the junction, you will still use the at-grade road, but with fewer competing turning movements sharing the signal phases and some stretches widened.

What is confirmed is the structural change: turning movements are being physically separated from through movements, which is the standard engineering method for reducing signal-cycle length and queue buildup at high-conflict junctions.

Noida-Delhi Flyover & Faridabad-Noida Connectivity: Impact on the Wider NCR Network

The Kalindi Kunj project does not exist in isolation - it sits inside a cluster of ongoing NCR infrastructure upgrades that are relevant context for anyone tracking this corridor:

Key Numbers
- 59 km - length of the DND–Faridabad–KMP Expressway spur (NH-148NA)
- 94.23% - completion of the final Mithapur–DND stretch as of December 2025
- 3.9 km - length of the Tughlakabad–Kalindi Kunj Metro extension
- ₹12,014.91 crore - total cost of Delhi Metro Phase V(A), of which this extension is one part
- 2028 - expected completion year for the metro extension (separate from the road flyovers)
  • DND–Faridabad–KMP Expressway (NH-148NA): This 59-km, six-lane spur of the Delhi–Mumbai Expressway connects the DND Flyway/Maharani Bagh interchange in Delhi to the KMP Expressway at Khalilpur near Sohna, passing through the Faridabad bypass. The Kalindi Kunj metro station area is one of only two Delhi-side entry/exit points for this spur (the other being the DND/Maharani Bagh interchange). The Sector 65–Sohna stretch opened in 2023, and the Jaitpur/Mithapur–Sector 65 stretch opened on November 12, 2024. The final 9-km Mithapur–DND stretch was, per Minister Gadkari's written Lok Sabha reply, 94.23% complete as of December 2025, with completion expected around June 2026 though this has already faced earlier delays linked to canal-crossing drawing approvals.

  • Ashram–Badarpur corridor: A separate, parallel signal-free upgrade (three flyovers) is planned for this stretch, also under NHAI, with DPRs being prepared alongside the Kalindi Kunj project.

  • Faridabad–Sohna spur to Jewar Airport: A further 31-km link is planned from the Sector-65 Faridabad bypass to Noida International Airport at Jewar, extending the long-term relevance of this corridor for airport-bound traffic.

  • Tughlakabad–Kalindi Kunj Metro corridor: Approved by the Union Cabinet in December 2025 as part of Delhi Metro's Phase V(A) project (total cost ₹12,014.91 crore for 16.076 km across three corridors). This specific 3.9-km extension will connect the under-construction Golden Line (Aerocity–Tughlakabad) to the existing Magenta Line at Kalindi Kunj, with three new stations: Sarita Vihar Depot, Madanpur Khadar, and Kalindi Kunj. Per Delhi Metro's own project tracking, this extension is expected to be completed by 2028 - a separate timeline from the road flyovers, and commuters should not conflate the two projects' completion dates.

Together, these projects point toward Kalindi Kunj becoming a genuine multi-modal interchange zone - road, expressway, and metro - over the next few years, even though each component is on its own independent approval and construction track.

Possible Impact on Real Estate

Confirmed infrastructure facts:

  • The Kalindi Kunj flyover project, the DND–Faridabad–KMP expressway link, and the Tughlakabad–Kalindi Kunj metro extension are all real, approved (at least in DPR/Cabinet-approval stage) infrastructure projects with identified implementing agencies.
  • These projects, once complete, will improve physical road and metro connectivity between South Delhi, Noida, and Faridabad via this corridor.

Possible real estate impact clearly labelled as speculation:

Real estate advisory reports (not government sources) point to strong recent price appreciation in several Noida localities often discussed in connection with this corridor including Sector 37, Sector 44, Sector 94, and Sector 150 with industry data from portals like 99acres citing appreciation ranging roughly from 10% to over 100% over three-to-five-year periods in specific micro-markets.

However, these figures are tied to a broader basket of drivers the Noida-Greater Noida Expressway, the Aqua Line metro, and the under-construction Noida International Airport at Jewar and no official report or independent study currently isolates the specific price effect of the Kalindi Kunj flyover project on these or any other locality.

Challenges

Several practical challenges are worth flagging, based on what officials and technical experts have said publicly:

  • No published construction timeline means the project could still face further delays at the tendering or land-acquisition stage before ground work even begins a pattern seen with the adjacent DND–Faridabad–KMP expressway link, whose final 9-km stretch has already slipped past its original May 2025 target.
  • Traffic management during construction at an already-saturated junction will be a major execution challenge; NHAI has not yet detailed a construction-phase traffic diversion plan.
  • Land and utility constraints around the Yamuna floodplain, Okhla Bird Sanctuary buffer zone, and existing metro/expressway infrastructure could require careful coordination between NHAI, DMRC, the UP government, and Delhi authorities, though no specific environmental clearance issue has been officially flagged for this project as of this writing.
  • Multi-agency coordination: the project involves Delhi Traffic Police, Noida (UP) Traffic Police, NHAI, and indirectly DMRC (given the adjacent metro corridor) and the Delhi government coordination delays of this kind have affected the pace of earlier Kalindi Kunj-area proposals, including the interchange concept first recommended by the UP PWD feasibility study back in 2022, which took roughly three years to progress from feasibility study to DPR approval.

Conclusion

If completed as planned, the Kalindi Kunj Flyover Project could eliminate one of NCR's biggest traffic bottlenecks by separating conflicting traffic movements instead of forcing every vehicle through a single signalised junction. The engineering logic is sound and well-tested, this is essentially the same fix used at Dhaula Kuan and the project has now cleared its DPR and approval stage after tracing back to a 2022 feasibility study. But while funding and approvals are now in place, commuters will have to wait for NHAI to announce the construction schedule before this long-awaited transformation becomes reality.

Frequently Asked Questions

1. What is the Kalindi Kunj flyover project?

It is an NHAI-approved plan to build two loop flyovers and widen parts of the existing Kalindi Kunj intersection, converting the Delhi-Noida-Faridabad junction into a signal-free interchange.

2. Is the Kalindi Kunj Flyover approved?

Yes. The DPR was completed and presented to Delhi Traffic Police, Noida Traffic Police, and NHAI officials on April 8, 2026, and the project received NHAI approval at that meeting. Construction has not yet started.

3. Who is building the Kalindi Kunj Flyover?

The National Highways Authority of India (NHAI) is the implementing agency. No construction contractor has been publicly announced yet.

4. When will construction begin?

No official construction start date has been announced. The DPR has been completed and the project approved (April 2026), but tendering and construction timelines are not yet public.

5. Where will the flyovers start and end?

Loop 1 runs from the Noida side of the Kalindi Kunj Bridge toward Faridabad/the Delhi–Mumbai Expressway. Loop 2 runs from the Faridabad/Expressway side to Noida via Okhla Barrage Road. A related flyover link connects the Madanpur Khadar police intersection to Noida with a return connection. Exact alignment drawings have not been made public.

6. Why is Kalindi Kunj always congested?

Because six roads converge at one signalised junction Noida, South Delhi/Shaheen Bagh, Faridabad, and the Delhi–Mumbai Expressway all merge here forcing turning and through traffic to share the same long, multi-phase signal cycle.

7. Will Kalindi Kunj become signal-free?

Yes, officials from Delhi Traffic Police and NHAI have confirmed the goal is to make the junction signal-free once the two loop flyovers are operational, though the existing at-grade crossing will remain in use for some through-movements.

8. How will Noida commuters benefit?

Noida-bound and Noida-originating traffic headed to/from Faridabad and the Delhi–Mumbai Expressway will be able to use dedicated loop ramps instead of waiting at the main signal.

9. Will Faridabad traffic reduce at Kalindi Kunj?

The project specifically targets Faridabad/Expressway-to-Noida traffic, which officials say has increased since Delhi–Mumbai Expressway sections opened, by giving it a dedicated loop (Loop 2) via Okhla Barrage Road.

10. How will Delhi–Mumbai Expressway connectivity improve?

The Kalindi Kunj metro station area is one of two Delhi-side access points to the DND–Faridabad–KMP spur (NH-148NA) of the Delhi–Mumbai Expressway. Removing signal delays at this junction should smooth entry/exit for Expressway-bound traffic, though no official time-saving figure has been published.

11. Will property prices increase because of this flyover?

This has not been confirmed by any government or independent study. Noida-area property appreciation reported by real estate portals is linked to multiple factors (metro expansion, Jewar Airport, expressway growth) and cannot be attributed specifically to this flyover project. Treat any price-appreciation claims tied solely to this project with caution.

12. Is the DPR approved?

Yes. The DPR was completed and presented to Delhi Traffic Police, Noida Traffic Police, and NHAI officials on April 8, 2026, and the project received NHAI approval at that meeting.

13. How many flyovers are planned?

Two loop flyovers (referred to as Loop 1 and Loop 2), plus a related flyover link connecting the Madanpur Khadar police intersection to Noida with a return connection, as per the DPR.

14. What is the estimated project cost?

Approximately ₹500 crore, sanctioned by Union Minister Nitin Gadkari, though a final itemised cost breakup has not been publicly released.

15. Is this the same as the Kalindi Kunj Metro project?

No. The Tughlakabad–Kalindi Kunj Metro corridor (3.9 km, part of Delhi Metro Phase V(A), approved by the Union Cabinet in December 2025) is a separate project with its own timeline (expected by 2028). The flyover project is a road-based NHAI initiative with no published completion date.

16. Will the existing Kalindi Kunj intersection be removed?

No. Officials have confirmed the existing intersection will remain functional; it will be widened at some stretches and made signal-free once the loop flyovers are complete.

17. Which areas will see the most traffic relief?

Areas most directly affected include Noida (Sectors 37–62 corridor), Jasola, Sarita Vihar, Shaheen Bagh, Madanpur Khadar, Okhla, and Faridabad/Ballabhgarh though specific relief levels have not been officially quantified.

18. Is this project connected to the Ashram-Badarpur flyover project?

They are separate but related projects. Both are being developed by NHAI as part of a broader push to make key Delhi corridors signal-free, and DPRs for both were referenced together in MoRTH's February 2026 Lok Sabha update.

19. What is the latest update on the Kalindi Kunj Flyover project (July 2026)?

As of July 2026, the DPR is complete and NHAI has approved the project with an estimated ₹500 crore budget sanctioned by Minister Gadkari. No construction start date or contractor has been announced yet this remains the single biggest open question on the project.

20. How long will the new flyovers be?

Exact flyover lengths have not been published in the approved DPR summary available publicly. An earlier mid-2025 proposal referenced a roughly 500-metre interchange concept, but this figure predates the final DPR and should not be treated as confirmed.
