Delhi is planning one of its biggest road infrastructure projects in decades — a proposed 55 km double-decker corridor above the existing Ring Road. If completed, it could reduce travel time by up to 40%, improve connectivity across North, Central and South Delhi, and influence property markets in several established micro-markets.

Because the proposed corridor passes through several of Delhi's busiest residential and commercial districts, it has become a key point of interest for commuters, businesses, homebuyers, and investors alike. For anyone with a stake in property or daily commutes along this stretch — from Azadpur and Netaji Subhash Place to Rajouri Garden and the DND approach — understanding exactly what's approved, what's still on paper, and what the real cost and timeline look like is essential before making any decision.

One clarification before we go further: This project (the Mahatma Gandhi Road / Ring Road elevated double-decker corridor) is separate from Delhi's four standalone double-decker metro-cum-road flyovers planned under Metro Phase IV (Bhajanpura, Saket, Madhuban Chowk, Peera Garhi) and from the Mehrauli-Badarpur Road double-decker package. This article covers only the 55-km Ring Road corridor project.

Latest Update (June 2026)

  • Phase 1 approved — roughly 25 km across three packages
  • Cost revised to ₹12,000 crore — up from earlier ₹6,000–7,000 crore estimates
  • DPR submitted by consultant AECOM India; under technical review
  • Construction expected after DPR finalisation — targeted by end of 2026
  • Two new Yamuna bridges included in the approved Phase 1 scope
  • The project was approved by the Delhi Government, with Chief Minister Rekha Gupta's sign-off reported alongside the Phase 1 clearance

Quick Project Overview

ParameterDetailsStatus
Project TypeElevated double-decker corridor built above an existing at-grade roadConfirmed
Total Length55 km, above the Mahatma Gandhi Road / Ring Road loopConfirmed
Total Phases (Structural Division)6Confirmed
Current StagePhase 1 approved; DPR for full corridor submitted and under reviewApproved (Phase 1 only)
Implementing AgencyPublic Works Department (PWD), Govt. of NCT of DelhiConfirmed
DPR ConsultantAECOM India Pvt. Ltd.Confirmed
Estimated Cost (Latest)₹12,000 croreApproved figure, June 2026
Phase 1 Length~25 km, made up of 3 packages (already cleared)Approved
River Crossings2 new Yamuna bridges (Chandgi Ram Akhara; Lohe Ka Pul / Iron Bridge)Approved as part of Phase 1
Interchanges (Planned)15Per project blueprint
Access Points (Planned)23Per project blueprint
Metro IntegrationLinked with Metro stations and transport hubs along the route; not a metro-carrying deckPlanned
Expected Travel Time SavingsUp to 40%Government projection, not yet verified
Construction StartTargeted end of 2026, after DPR finalisationStated target, unconfirmed

Why Was This Project Proposed?

Delhi's Ring Road system carries a traffic load the city's flat road network can no longer absorb. During rush hours, it can take up to two hours to cover 30 km on certain corridors. Delhi had over 8.41 million registered vehicles as of the most recent official count (2024), with two-wheelers and cars together making up 92% of that fleet — and more than 700,000 new vehicles were added in 2024 alone.

Older but widely cited CRRI-linked research found that Delhi's congestion roughly doubled over an eight-to-ten-year stretch, with millions of productive hours and significant fuel value lost annually to gridlock. The same research argued that widening the Ring Road was the only road-level fix available — because the city had largely run out of room to expand horizontally.

This is the underlying logic for going vertical: Delhi can't expand its road footprint much further in a dense, already-built city, so PWD's approach is to add a second deck rather than acquire new land. CRRI experts quoted in recent reporting echo this — calling the project technically demanding but necessary precisely because horizontal expansion isn't realistic on these stretches anymore.

Complete Route Analysis

The corridor begins at Azadpur Flyover, travels east toward Kashmere Gate, crosses the Yamuna near Chandgi Ram Akhara, continues past ISBT and ITO to the DND Flyway, then loops west toward Moti Bagh, Rajouri Garden, Pitampura, Netaji Subhash Place, and finally reconnects at Azadpur — a full 55-km loop above the existing Ring Road.

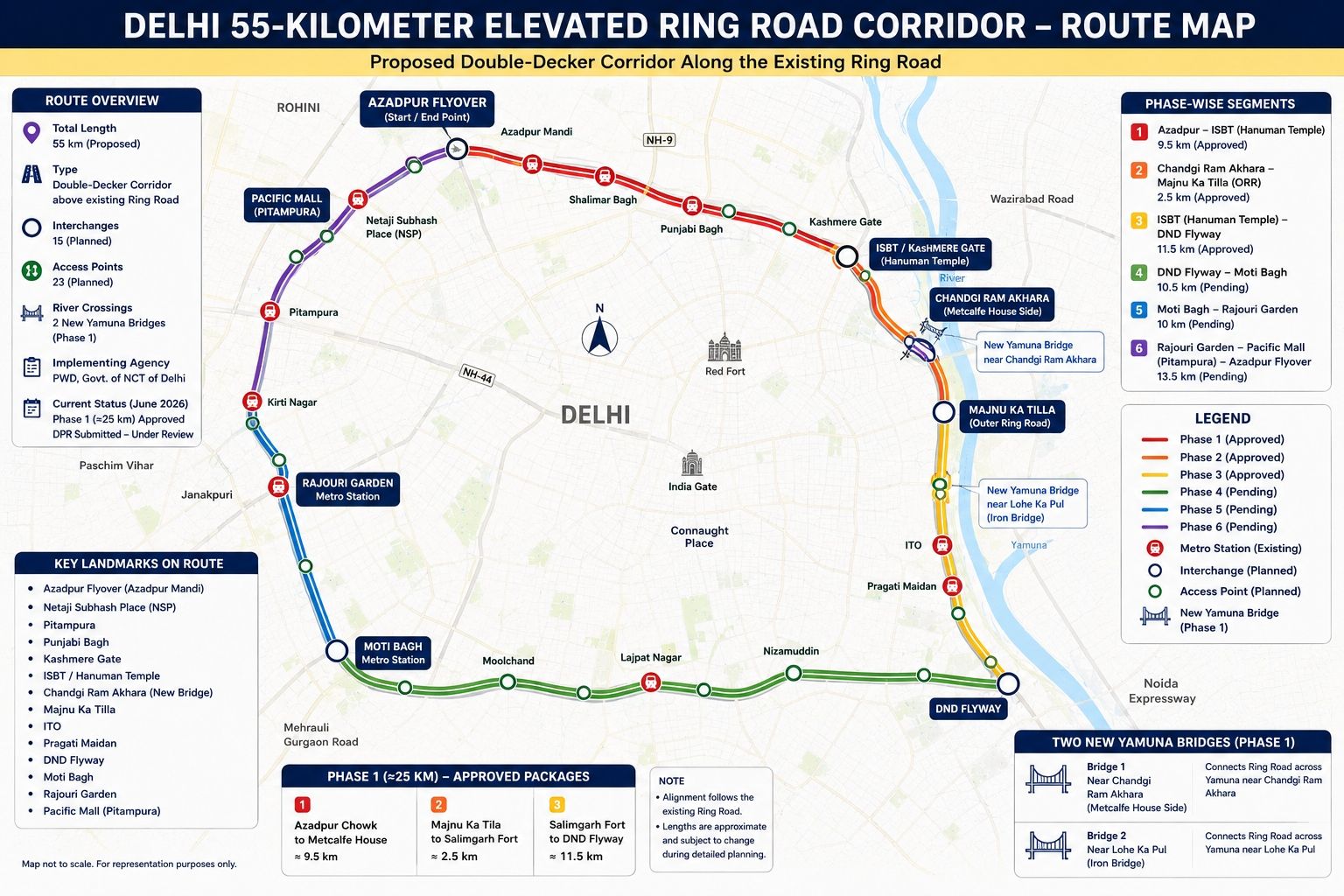

Delhi 55-kilometer Elevated Ring Road Corridor.jpg

Structurally, it is divided into six phases:

SegmentApprox. LengthMetro/Landmark ContextPhase Status
Azadpur Flyover (Mandi) – Hanuman Temple (ISBT)9.5 kmAzadpur Metro; Azadpur MandiPhase 1 — Approved
Chandgi Ram Akhara – Majnu Ka Tilla (Outer Ring Road)2.5 kmNew Yamuna bridge herePhase 1 — Approved
Hanuman Temple (ISBT) – DND Flyover11.5 kmKashmere Gate, ITO vicinityPhase 1 — Approved
DND Flyover – Moti Bagh Metro Station10.5 kmMoti Bagh MetroLater Phase — Pending
Moti Bagh Metro Station – Rajouri Garden10 kmRajouri Garden MetroLater Phase — Pending
Rajouri Garden – Pacific Mall (Pitampura) – Azadpur Flyover13.5 kmNSP, PitampuraLater Phase — Pending, closes loop

Also Read this:- Shiv Murti to Nelson Mandela Marg Tunnel: Route, Cost, Timeline, Benefits & Impact on Delhi Gurugram Travel

Phase 1 (approved, ~25 km) breaks down into three specific packages:

  • Azadpur Chowk to Metcalfe House
  • Majnu Ka Tila to Salimgarh Fort
  • Salimgarh Fort to the DND Flyway Two new Yamuna river crossings are central to Phase 1:
  • Bridge near Chandgi Ram Akhara (close to Metcalfe House) — strengthens connectivity to North-East Delhi, ITO, and Mayur Vihar, with planned future integration with the Delhi–Dehradun Expressway corridor.
  • Bridge near Lohe Ka Pul (Iron Bridge) — replaces the ageing existing structure and eases pressure on the heavily used ITO Bridge and Yudhister Setu.

Engineering Design

The core concept: an additional road level is built directly above the existing Ring Road carriageway, largely within the current footprint, rather than acquiring new land alongside it.

Note: PWD has not published project-level engineering specifications. Engineering details below are based on comparable Indian elevated corridor projects and confirmed design elements where available. Nothing in this section should be read as confirmed specifics for this corridor.

Confirmed design elements:

  • Vertical clearance: In sections passing over existing flyovers and Metro viaducts, the elevated layer may need to reach roughly 15–20 metres — effectively a third road layer in places where a flyover already exists.
  • Traffic segregation: The upper deck carries long-distance, signal-free through-traffic; the existing ground-level road continues to handle local and access traffic.
  • Interchanges and access: 15 interchanges and 23 access points are part of the current blueprint.
  • Pedestrian and cycling infrastructure: Dedicated tracks and smart traffic-management systems are part of the design brief. Likely construction approach (based on comparable Indian elevated corridors): Foundations at this scale typically use bored, cast-in-situ pile foundations. Pier spacing on comparable urban corridors commonly falls in the 30–40 metre range. Precast segmental box girders or precast I-girders are the standard superstructure choice, cast off-site and launched into position to minimise disruption to the road below. Utility shifting of power, water, and telecom lines ahead of pier construction is standard practice in dense corridors like Wazirpur and Azadpur Mandi.

Environmental and structural studies (confirmed): AECOM India has been tasked with topographical and environmental-impact assessments alongside core structural design, folded into the DPR.

Project Timeline

DateMilestoneStatus
June 2025Project formally announced under Delhi's city decongestion plan; six phases outlined; cost cited at ₹7,000 crore.Announced
July 2025A separate contemporaneous report described a ₹6,000 crore, toll-based variant of the elevated corridor proposal (~80 km including loops/ramps); PWD directed to fast-track consultant appointment.Reported — Possibly an early/alternate framing of the same plan
November 2025PWD formally launched redevelopment; AECOM India appointed for DPR across all six phases; 24-week DPR timeline set.DPR Commissioned
April 2026DPR submitted by consultants and placed under government review; cost still cited at ₹7,000 crore in most coverage.DPR Under Review
June 19–21, 2026Delhi Government approved the project; Phase 1 (3 packages, ~25 km) cleared; cost revised to ₹12,000 crore; two new Yamuna bridges confirmed.Phase 1 Approved
End of 2026 (Target)Construction expected to begin on Phase 1.Targeted, Unconfirmed
Not Yet AnnouncedStart dates for the remaining phases.Pending

Cost Analysis: Why Did the Estimate Roughly Double?

The cited cost moved from ₹6,000 crore (mid-2025) to ₹7,000 crore (late 2025/early 2026) to ₹12,000 crore at the June 2026 Phase 1 approval. None of the available sources explain this escalation explicitly, but a few plausible drivers stand out:

  • DPR-stage refinement: Early proposal-stage figures are almost always rough estimates. Once a consultant completes detailed engineering, traffic modelling, and site assessment — as AECOM has now done — costs typically rise as real ground conditions and structural requirements get factored in.
  • Scope addition: The two new Yamuna bridges were not clearly costed into the earlier ₹6,000–7,000 crore figures. Large urban bridge structures often distort simple cost-per-km comparisons because a few kilometres of river crossing can account for a disproportionate share of project cost.
  • Utility shifting and dense-corridor construction: Wazirpur, Azadpur Mandi, and the ISBT belt are dense commercial/industrial zones where utility relocation adds significant cost that's hard to estimate accurately before detailed surveys.
  • Elevated construction at height: Sections needing 15–20 metre clearance require more material and more complex construction than a standard single-level elevated road. A cost-per-km comparison, with caveats: Bengaluru's 11-corridor DPR (126 km) was costed at roughly ₹142 crore per km. Applying that to Delhi's 55 km suggests a ballpark of ~₹7,800 crore — noticeably below Delhi's ₹12,000 crore. The gap is largely explained by Delhi's two major river crossings, denser utility shifting, and the complexity of building over existing flyovers and Metro viaducts. Cost escalation between proposal and execution is the norm rather than the exception for large Indian urban infrastructure projects. Bengaluru's own Business Corridor saw its estimate go from ₹3,000 crore to ₹27,000 crore over nearly two decades.

Expected Benefits

  • Travel time: Officials cite up to 40% reduction along the corridor — a government projection, not yet independently verified.
  • Congestion relief at junctions: Separating long-distance and local traffic onto different levels should reduce junction-level congestion on routes currently among the city's slowest.
  • East-west connectivity: The two new Yamuna bridges specifically target cross-river connectivity between North-East Delhi and the western Ring Road loop.
  • Multimodal integration: Planned connections with Metro stations and transport hubs along the route.
  • Sustainability features: Dedicated cycling tracks, pedestrian pathways, and green construction materials are part of the stated design brief.

Check this:- Delhi Metro Phase V(B): 7 New Corridors, 65 Stations, Cost, Timeline and Route Details

Challenges That Could Delay the Project

  • Environmental clearance: River-crossing structures near the Yamuna floodplain typically require clearance processes that can extend timelines — no status has been published yet for the two new bridges.
  • Yamuna floodplain construction: Building bridge approaches and piers near the floodplain involves additional geotechnical and hydrological assessment, historically a slow-moving clearance category in Delhi.
  • Utility shifting: Power, water, and telecom relocation in dense zones like Wazirpur and Azadpur Mandi is a recurring bottleneck in Delhi infrastructure projects.
  • Metro line conflicts: PWD has explicitly flagged that corridors beyond Phase 1 face "technical challenges, including space constraints and the metro line" — meaning structural coordination with existing Metro viaducts will be harder there.
  • Heritage zone proximity: The corridor passes near heritage-sensitive areas (Salimgarh Fort, the historic Lohe Ka Pul/Iron Bridge), which can trigger additional clearance requirements.
  • Funding and tendering: No tender documents have been published yet for Phase 1 construction packages. Until tenders are floated and awarded, "approved" should be read as a planning and budgetary milestone, not a construction commitment.
  • Cost escalation risk: The near-doubling of the cost estimate within about a year is itself evidence that budget overruns remain a live risk.

Comparison With Similar Projects

ProjectLengthCostStatus (Mid-2026)Real Estate Impact Observed
Delhi Ring Road Double-Decker Corridor55 km₹12,000 crore (latest)Phase 1 (25 km) approved; construction not startedToo early — unbuilt
Dwarka Expressway29 km~₹4,100 crore (Haryana segment)OperationalPrices rose roughly 3.5× between 2020 and 2025, from ~₹6,300/sq ft to ₹21,700–24,000/sq ft.
Delhi–Meerut Expressway~96 kmOperationalIndirapuram saw ~73% price growth over four years, partly attributed to the expressway and the RRTS corridor.
Delhi–Dehradun Expressway213 km₹12,000 croreOperational (April 2026)Experts project 15–25% appreciation in key micro-markets over 18–24 months after opening.
Bengaluru Elevated Corridors (11-Corridor Package)75.6 km₹13,262 croreCabinet-approved (April 2026); construction not yet startedToo early — unbuilt; comparable approval-to-construction timeline to Delhi's project.
Santacruz–Chembur Link Road, Mumbai (India's first double-decker flyover)6.45 km₹454 croreOperational since 2014Handles over 75,000 vehicles daily; travel time reduced from 60–90 minutes to 15–20 minutes.

Mumbai's SCLR is the closest direct double-decker precedent in India, but it still took over 11 years to complete — delayed by land acquisition disputes, utility shifting complexity, engineering revisions, and litigation that collectively pushed the project well past its original schedule. Delhi's corridor is nearly nine times longer. That context matters, but it also doesn't mean Delhi will automatically repeat the same pattern: Delhi's project is built above an existing road with minimal land acquisition required, which removes one of the biggest delay factors that hobbled Mumbai's SCLR. Bengaluru's 11-corridor package, approved around the same time as Delhi's Phase 1, offers a useful live parallel in terms of scale and pre-construction uncertainty.

On the real estate side, genuine large appreciation in comparable Delhi-NCR corridors has historically materialised over a multi-year horizon after substantial construction progress — not at the announcement or DPR stage.

Real Estate Impact

Why Timing Matters More Than Location

The single most useful distinction for property decisions is when a location's benefit is likely to arrive — not just whether it sits "on the corridor."

Phase 1 beneficiaries (approved, construction expected first):

  • Azadpur, ISBT / Kashmere Gate, Majnu Ka Tilla, DND approach These areas will see actual construction activity first — but also absorb disruption first. Any real estate benefit here is realistic on a multi-year horizon, once Phase 1 is substantially complete.

Long-term beneficiaries (later phases, unapproved, no confirmed timeline):

  • Netaji Subhash Place, Rajouri Garden, Punjabi Bagh, Moti Bagh

These areas sit on parts of the loop with no approved start date. Their benefit timing depends entirely on whether and when those phases get approved — which could be years away, or could stall indefinitely.

Based on comparable corridors, announcement-stage appreciation has historically been limited. The strongest price movement typically occurs after visible construction progress and before commissioning — not at approval or DPR stage.

Residential Impact

The corridor's residential influence zone covers established North and West Delhi neighbourhoods — largely built out, with limited new land supply, meaning demand shifts are more likely to show up as price appreciation on existing stock than as a wave of new launches. Buyers along Phase 1 stretches should factor in years of construction-adjacent disruption before any connectivity benefit materialises.

Commercial Impact

  • Office demand: Improved signal-free connectivity could enhance NSP's draw as a Grade-B/B+ office alternative to Gurgaon and central Delhi.
  • Retail and mixed-use: Malls and retail clusters at NSP and Pitampura are positioned to benefit once construction-phase disruption ends.
  • Industrial/warehousing: Wazirpur's 2,000+ industrial units could see meaningful freight-efficiency gains from better through-traffic flow.

Check this:- Shastri Park to Mayur Vihar Phase 3 Metro Route Map, Cost, Timeline and Benefits

Micro-Market Analysis

Netaji Subhash Place (NSP)

MetricFigure
Premium Office Rent₹90–180/sq ft/month
Standard Office Rent₹60–120/sq ft/month
ConnectivityOuter Ring Road; Red–Pink Metro interchange
Investment OutlookIncremental gains likely; mature market with limited new supply

NSP is already North Delhi's most established commercial hub, anchored by the Metro Station (Red-Pink Line interchange). It draws IT/ITES firms, BPO and back-office operations, consultancies, and SME corporates — businesses that need a professional, well-connected address without paying Connaught Place or Gurgaon rents.

NSP vs. Connaught Place: CP remains Delhi's prestige CBD, commanding higher rents and attracting legal, government-adjacent, and heritage-brand corporates. NSP competes on value: comparable Metro connectivity, substantially lower rent, and a more IT/ITES-oriented tenant base.

NSP vs. Gurugram: Gurugram's Cyber City and Golf Course Road corridors offer larger Grade A campuses and a denser concentration of MNC headquarters and GCCs, but at a real commute cost for North and West Delhi-based talent. NSP's pitch is the reverse: smaller-format flexible office stock, shorter commutes for North Delhi residents, and meaningfully lower occupancy costs — better suited to SMEs and mid-sized teams than large campuses.

Grade A vs. Grade B stock: NSP's commercial stock is a mix — modern twin-tower developments like Aggarwal Cyber Plaza and PP Towers offer Grade A-adjacent specifications, while a larger share of older buildings sit in the Grade B range. This is why NSP's rent range is wide (₹60–180/sq ft/month) rather than a tight band.

Why hasn't NSP grown as fast as Gurgaon? Primarily because Gurgaon had an enormous advantage in undeveloped land — it could build large-format campuses from scratch in the 2000s and 2010s while Delhi's established zones like NSP had little room for greenfield development. NSP's stock grew incrementally within an already-dense built environment, which naturally limits the scale of new supply and attracts a different, typically smaller-format occupier profile. Road-level congestion has been the other consistent drag — repeatedly flagged by businesses as NSP's most persistent weak point, and directly relevant to what this corridor is designed to address.

Is connectivity the current bottleneck? Yes — NSP's Metro connectivity is already a genuine strength, but road-level congestion at peak hours is the recurring weak point cited by businesses and commuters. This is precisely the kind of constraint the double-decker corridor is designed to address, which is why NSP is reasonably positioned to benefit if and when its phase of the corridor is approved and built — though that remains a later, unapproved phase.

Wazirpur

Known as Delhi's "steel hub," Wazirpur Industrial Area hosts over 2,000 industrial units, increasingly mixed with corporate offices and showrooms. The area is undergoing separate internal infrastructure upgrades independent of the Ring Road project. Its gradual shift toward a mixed industrial-commercial zone, combined with potential freight gains from the corridor, makes it a longer-horizon redevelopment play rather than a near-term residential investment.

Azadpur

Home to Asia's largest wholesale fruit and vegetable market and a key Metro/rail interchange point. Azadpur marks the starting point of multiple Phase 1 packages, making it one of the first areas to see construction activity. Benefits accrue mainly to logistics and wholesale trade.

Shalimar Bagh

MetricFigure
Average Price per sq ft₹9,950–15,000
Monthly Rent Range₹14,000–45,000
Investment OutlookStable, end-user-driven; unlikely to see speculative repricing on announcement alone

Rohini

MetricFigure
Average Flat Rate₹11,100–14,100/sq ft
Affordable SectorsSectors 16, 34, Narela, Burari (~₹8,000/sq ft)
Upscale SectorsSectors 9, 13, 14
Recent 1-Year Appreciation~13.3% (broader Delhi market trend, not corridor-specific)

Rohini's scale and sector diversity mean any corridor-driven uplift will likely be sector-specific rather than market-wide.

Punjabi Bagh

MetricFigure
Average Flat Rate₹13,450–19,850/sq ft
Builder Floor 1-Year Change~+5.3%
Phase RelevanceLater phase (Moti Bagh–Rajouri Garden); unapproved, further out

Price and Outlook Snapshot

AreaCurrent Price RangeInvestment Outlook
Netaji Subhash Place (Office)₹60–180/sq ft/month rentIncremental gains; mature market
WazirpurMixed industrial/commercial pricingLong-horizon redevelopment play
Shalimar Bagh₹9,950–15,000/sq ftStable, end-user driven
Rohini₹11,100–14,100/sq ftSector-specific gains likely
Punjabi Bagh₹13,450–19,850/sq ftLater-phase, longer horizon
AreaShort-Term (0–18 Months)Long-Term (3–5+ Years)
Azadpur, Majnu Ka Tilla, Salimgarh Fort (Phase 1)Construction disruption; limited price movementGenuine connectivity upside once complete
NSP, WazirpurLargely unaffected near-termFreight and commercial efficiency gains over time
Rohini, Shalimar Bagh, Punjabi BaghNo direct near-term impactDepends entirely on later-phase approval timing

Investment Advice by Buyer Type

End users (residential): Treat this as a long-term structural positive for the corridor, not a reason for urgent action — especially in Phase 1 areas, which will see years of construction disruption first.

Commercial buyers: NSP and Wazirpur-adjacent commercial assets are reasonable medium-term considerations given existing maturity and direct corridor proximity, but factor in construction-phase disruption to footfall and access.

Investors (capital appreciation focused): The more reliable signal isn't this approval news itself, but visible tender awards, ground-breaking, and Phase 1 progress reports over the next 12–18 months. Comparable corridors show the bulk of appreciation arrives after, not before, construction is visibly underway.

Retail shop owners/lessees: Footfall-dependent retail near Phase 1 construction zones should expect temporary disruption before any connectivity-driven footfall increase.

Warehousing/logistics operators: Wazirpur and Azadpur-adjacent logistics operations are well-positioned for freight-efficiency gains once the corridor is operational — though on a multi-year horizon.

Investment Advice by Time Horizon

Time HorizonOutlook
0–2 YearsConstruction disruption is likely to outweigh any gains in Phase 1 areas. Later-phase locations (NSP, Rajouri Garden, Punjabi Bagh, and Moti Bagh) are unlikely to see direct project impact because those phases have not yet been approved.
3–5 YearsIf Phase 1 remains broadly on schedule, connectivity benefits in the Azadpur–DND corridor should begin to emerge. This period should also provide greater clarity on whether later phases receive approval or face further delays.
5–10 YearsThere is potential for sustained appreciation across the full corridor if all phases are completed. However, this outcome depends heavily on timely approvals and disciplined project execution, as a significant portion of the corridor remains unapproved.

Frequently Asked Questions

What is Delhi's 55-km Double-Decker Corridor?

An elevated road corridor being built directly above the existing Mahatma Gandhi Road (Ring Road), creating a two-level system where long-distance traffic uses the upper deck and local traffic continues on the existing ground-level road.

Why is it called a "double-decker" corridor?

The name refers to the road structure itself, not a Metro line. The project adds a second, elevated road level directly above the existing Ring Road. This is a common point of confusion because Delhi separately has four standalone double-decker structures under Metro Phase IV that do carry Metro rail on their upper deck — but this 55-km Ring Road project is road-only on both levels.

Is the Delhi Double-Decker Corridor approved?

Phase 1 (~25 km, three packages) was approved by the Delhi Government in June 2026, with Chief Minister Rekha Gupta's sign-off reported alongside the clearance. The remaining phases are not yet approved and have no confirmed timeline.

Has construction started?

No. As of late June 2026, the DPR is under technical review and construction is only a stated target for "end of 2026" on Phase 1 — not a confirmed start date.

What is the official route?

It follows the existing 55-km Ring Road loop across six phases: Azadpur–Hanuman Temple (ISBT), Chandgi Ram Akhara–Majnu Ka Tilla, Hanuman Temple–DND Flyover, DND Flyover–Moti Bagh, Moti Bagh–Rajouri Garden, and Rajouri Garden–Azadpur (via Pitampura).

What is the estimated cost?

The latest figure, tied to the June 2026 Phase 1 approval, is ₹12,000 crore — up from ₹6,000–7,000 crore reported through 2025 and early 2026.

Will property prices increase because of this project?

Some appreciation over time in directly affected micro-markets is plausible, based on comparable corridors. But significant price movement has historically taken several years and tracked actual construction progress — not the announcement or DPR stage this project is currently at.

When will construction start?

PWD officials have indicated Phase 1 construction could begin by the end of 2026, once the DPR is fully finalised. This is a stated target, not a contractually committed date.

When will the full project be completed?

No official completion date exists for either Phase 1 or the full corridor. With the later phases lacking approved timelines, full-corridor completion is likely several years out at minimum.

How many new Yamuna river crossings are planned?

Two — one near Chandgi Ram Akhara (close to Metcalfe House) and one near Lohe Ka Pul (Iron Bridge), both part of the approved Phase 1 scope.

What are the biggest risks to the project's timeline?

Cost escalation (already nearly doubled within about a year), utility-shifting complexity in dense commercial zones, environmental clearance near the Yamuna floodplain, and technical conflicts with existing Metro infrastructure on phases beyond Phase 1.

Should I buy property now in anticipation of this corridor?

That depends on your time horizon and risk tolerance. Comparable projects suggest waiting for visible construction progress — not just approval news — typically leads to better-timed entry, since most appreciation in similar corridors has historically come after, not before, ground-breaking.

Where can I track official project updates?

The PWD Delhi web portal (pwddelhi.gov.in) is the primary official source, though it doesn't yet carry a dedicated public project page for this corridor. Official PWD/Delhi government press statements remain the most reliable update source.


Share with

Contact Us

Fill out this form
& we'll get back
to you

Afghanistan
+93
Albania
+355
Algeria
+213
Andorra
+376
Angola
+244
Antigua and Barbuda
+1268
Argentina
+54
Armenia
+374
Aruba
+297
Australia
+61
Austria
+43
Azerbaijan
+994
Bahamas
+1242
Bahrain
+973
Bangladesh
+880
Barbados
+1246
Belarus
+375
Belgium
+32
Belize
+501
Benin
+229
Bhutan
+975
Bolivia
+591
Bosnia and Herzegovina
+387
Botswana
+267
Brazil
+55
British Indian Ocean Territory
+246
Brunei
+673
Bulgaria
+359
Burkina Faso
+226
Burundi
+257
Cambodia
+855
Cameroon
+237
Canada
+1
Cape Verde
+238
Caribbean Netherlands
+599
Cayman Islands
+1
Central African Republic
+236
Chad
+235
Chile
+56
China
+86
Colombia
+57
Comoros
+269
Congo
+243
Congo
+242
Costa Rica
+506
Côte d'Ivoire
+225
Croatia
+385
Cuba
+53
Curaçao
+599
Cyprus
+357
Czech Republic
+420
Denmark
+45
Djibouti
+253
Dominica
+1767
Dominican Republic
+1
Ecuador
+593
Egypt
+20
El Salvador
+503
Equatorial Guinea
+240
Eritrea
+291
Estonia
+372
Ethiopia
+251
Faroe Islands
+298
Fiji
+679
Finland
+358
France
+33
French Guiana
+594
French Polynesia
+689
Gabon
+241
Gambia
+220
Georgia
+995
Germany
+49
Ghana
+233
Greece
+30
Greenland
+299
Grenada
+1473
Guadeloupe
+590
Guam
+1671
Guatemala
+502
Guinea
+224
Guinea-Bissau
+245
Guyana
+592
Haiti
+509
Honduras
+504
Hong Kong
+852
Hungary
+36
Iceland
+354
India
+91
Indonesia
+62
Iran
+98
Iraq
+964
Ireland
+353
Israel
+972
Italy
+39
Jamaica
+1876
Japan
+81
Jordan
+962
Kazakhstan
+7
Kenya
+254
Kiribati
+686
Kosovo
+383
Kuwait
+965
Kyrgyzstan
+996
Laos
+856
Latvia
+371
Lebanon
+961
Lesotho
+266
Liberia
+231
Libya
+218
Liechtenstein
+423
Lithuania
+370
Luxembourg
+352
Macau
+853
Macedonia
+389
Madagascar
+261
Malawi
+265
Malaysia
+60
Maldives
+960
Mali
+223
Malta
+356
Marshall Islands
+692
Martinique
+596
Mauritania
+222
Mauritius
+230
Mayotte
+262
Mexico
+52
Micronesia
+691
Moldova
+373
Monaco
+377
Mongolia
+976
Montenegro
+382
Morocco
+212
Mozambique
+258
Myanmar
+95
Namibia
+264
Nauru
+674
Nepal
+977
Netherlands
+31
New Caledonia
+687
New Zealand
+64
Nicaragua
+505
Niger
+227
Nigeria
+234
North Korea
+850
Norway
+47
Oman
+968
Pakistan
+92
Palau
+680
Palestine
+970
Panama
+507
Papua New Guinea
+675
Paraguay
+595
Peru
+51
Philippines
+63
Poland
+48
Portugal
+351
Puerto Rico
+1
Qatar
+974
Réunion
+262
Romania
+40
Russia
+7
Rwanda
+250
Saint Kitts and Nevis
+1869
Saint Lucia
+1758
Saint Pierre & Miquelon
+508
Saint Vincent and the Grenadines
+1784
Samoa
+685
San Marino
+378
São Tomé and Príncipe
+239
Saudi Arabia
+966
Senegal
+221
Serbia
+381
Seychelles
+248
Sierra Leone
+232
Singapore
+65
Slovakia
+421
Slovenia
+386
Solomon Islands
+677
Somalia
+252
South Africa
+27
South Korea
+82
South Sudan
+211
Spain
+34
Sri Lanka
+94
Sudan
+249
Suriname
+597
Swaziland
+268
Sweden
+46
Switzerland
+41
Syria
+963
Taiwan
+886
Tajikistan
+992
Tanzania
+255
Thailand
+66
Timor-Leste
+670
Togo
+228
Tonga
+676
Trinidad and Tobago
+1868
Tunisia
+216
Turkey
+90
Turkmenistan
+993
Tuvalu
+688
Uganda
+256
Ukraine
+380
United Arab Emirates
+971
United Kingdom
+44
United States
+1
Uruguay
+598
Uzbekistan
+998
Vanuatu
+678
Vatican City
+39
Venezuela
+58
Vietnam
+84
Wallis & Futuna
+681
Yemen
+967
Zambia
+260
Zimbabwe
+263
